Launching an app is not the end of the development process. It is the point where planning finally meets real user behavior.
Before launch, product teams work mostly with assumptions. They estimate which features matter, which screens are intuitive, which devices will cause trouble, and how users will move through the product. After launch, those assumptions can be tested against crash reports, reviews, support tickets, retention data, funnel performance and actual feature usage.
That makes the post-launch roadmap fundamentally different from the pre-launch product plan.
A useful app update roadmap should not be a wish list of features. It should be a decision system for answering four questions:
What needs fixing now?
What should improve next?
What is worth building later?
What must be maintained even when users never ask for it?
That last question matters more than many teams expect. App stores, operating systems, SDKs, devices, privacy requirements and third-party services keep changing after the first release. Google Play, for example, requires new apps and app updates submitted from August 31, 2026 to target Android 16, API level 36, with specific exceptions for several device categories. Existing apps also face newer target-level requirements to remain fully discoverable to users on newer Android versions. Android Developers
An app that stands still is therefore not actually standing still. It is gradually falling behind the platform around it.
The right roadmap balances product growth with reliability, technical health and changing platform requirements.
Start the roadmap with evidence, not feature requests
The first version of a post-launch roadmap should be informed by what happens after people begin using the app.
That sounds obvious, but many teams carry their pre-launch backlog directly into production and continue building the next planned features without checking whether users are succeeding with the product that already exists.
A better approach begins by establishing a post-launch baseline.
You need to understand four broad areas.
Product usage
Which features are being used?
Which screens receive little engagement?
Where do users stop during onboarding, checkout, registration or another important flow?
Which actions correlate with continued usage?
These questions help separate features users actually value from features that simply looked important during planning.
Stability
How often does the app crash?
Are failures concentrated on particular devices, OS versions or app versions?
Are there Android ANRs, slow startup issues, failed requests or background errors?
Google's Android vitals tracks user-perceived crash rate, which measures the proportion of daily active users who experience a crash while actively using the app. Google currently treats this as a core vital and says excessive user-perceived crashes can reduce an app's discoverability on Google Play. Android Developers
Stability is therefore not merely an engineering metric. It can directly affect user experience and distribution.
Retention
Do users return?
Apple's App Store Connect Analytics provides retention by installation cohort and allows teams to filter the metric by app version, device, platform version, region and other dimensions. Apple explicitly positions retention as an indicator of long-term app health and a way to evaluate the effect of changes such as onboarding updates and new features. Apple Developer
A roadmap that increases feature count while retention deteriorates may be moving in the wrong direction.
User feedback
Support tickets, store reviews, interviews, customer success conversations and in-app feedback all provide context that analytics cannot.
Analytics may tell you where users drop.
Feedback may tell you why.
Neither source should be used alone.
A feature requested loudly by five users may not represent the broader market. Conversely, a statistically small issue may still deserve immediate attention if it blocks payments, creates data loss or affects an important customer segment.
The roadmap has to combine quantitative evidence with product judgment.

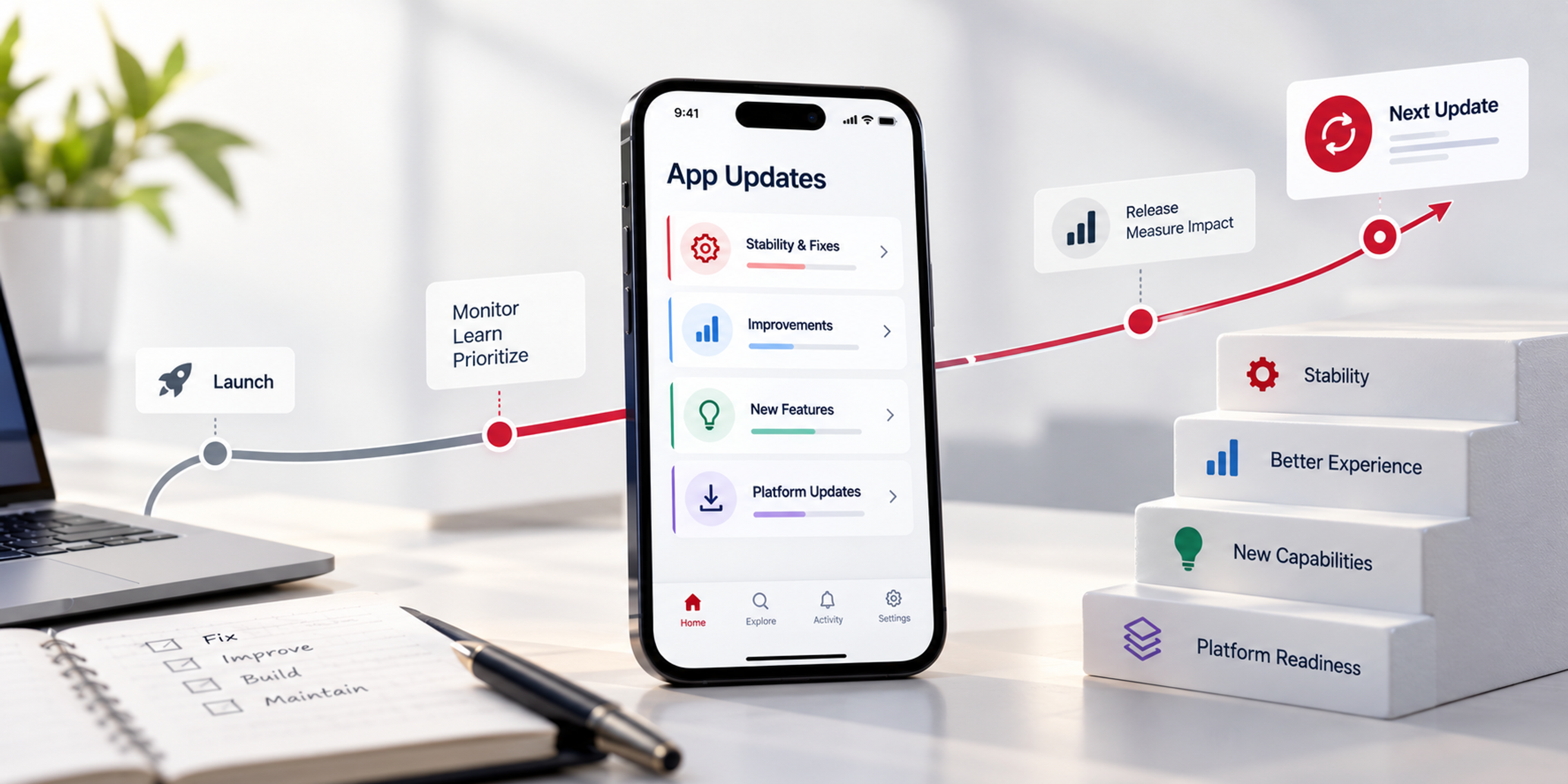

Build the roadmap around four types of work
One of the most useful ways to make an app roadmap realistic is to stop treating every backlog item as the same kind of work.
Most post-launch development falls into four categories.
1.Reliability and bug fixes
These include crashes, broken flows, failed payments, login problems, notification failures, data synchronization issues and other defects.
Some bugs can wait.
Others cannot.
The important distinction is severity, not simply the number of people reporting the problem.
A rare bug that causes data loss may deserve higher priority than an irritating interface issue seen by thousands of users.
Your roadmap should therefore include a fast path for critical defects rather than forcing everything into the normal feature-planning cycle.
2.Product improvements
These are refinements to functionality that already exists.
Examples include reducing the number of onboarding steps, improving search filters, simplifying checkout, making a form easier to complete or changing navigation based on observed usage.
These improvements are often less visible than new features, but they can have a larger impact.
If users already reach a feature but struggle to complete the task, improving that experience may generate more value than adding another capability.
3.New features
New functionality matters, especially when it helps the product address important customer needs or commercial goals.
But new features should compete for roadmap space with improvements and maintenance.
The dangerous pattern is allowing new development to consume nearly all capacity because it looks more exciting in stakeholder presentations.
The result is an app that becomes wider but increasingly fragile.
4.Maintenance and platform work
This includes SDK updates, dependency upgrades, operating-system compatibility, security patches, store-policy changes, analytics changes, infrastructure improvements and technical debt.
Users rarely request this work because most of it is invisible when done properly.
That does not make it optional.
Google Play's annual target API policy is a good example. Google says apps must target a recent Android API level, with updates generally required to target within one year of the latest major Android release. Failing to meet the requirement can block update submissions. Google Help
A roadmap that budgets only for visible user features is incomplete.
Do not use a single priority score blindly
Many product teams use RICE, ICE, value-versus-effort matrices or similar prioritization frameworks.
They can be useful, but app roadmaps often include items that should not be competing on one mathematical scale.
A mandatory SDK migration should not lose to a cosmetic feature because the cosmetic feature gets a better "reach" score.
A payment crash should not wait because its estimated development effort is higher than a minor interface improvement.
It is more practical to establish priority classes first.
For example:
Critical: security issue, data loss, payment failure, severe crash, store compliance blocker.
High: major user friction, high-volume failure, retention problem, strategically important capability.
Medium: meaningful feature enhancement, usability improvement, operational efficiency.
Low: cosmetic refinement, low-impact request, speculative feature.
Then use scoring within the class where it helps.
This prevents the roadmap from becoming falsely objective.
Product decisions still require judgment.
Separate urgency from importance
Another common problem is allowing every recent request to become urgent.
Sales teams may want a feature for a prospect.
Support may want a fix for the newest complaint.
Executives may want something demonstrated by a competitor.
Engineering may want a large refactor.
All of those requests can be legitimate. They are not automatically roadmap priorities.
A useful roadmap separates urgency from strategic importance.
An issue can be urgent but narrow.
Another can be important but safely scheduled for the next quarter.
A third can be both urgent and important.
This distinction gives teams room to respond without constantly rewriting the entire roadmap.
Create a release horizon instead of pretending the whole year is fixed
A twelve-month roadmap can be useful for direction.
It should not imply that every feature planned for month eleven is certain.
The further away a release is, the less precise the commitment should become.

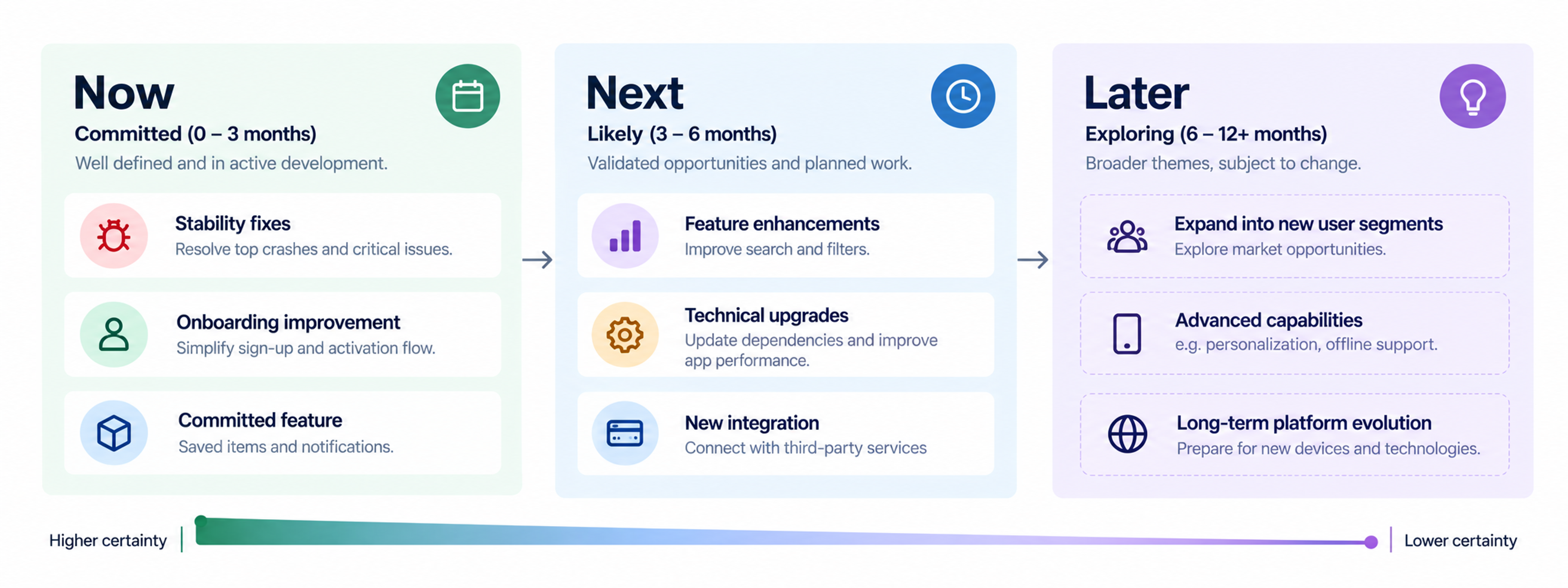

A practical roadmap can use three horizons.
Now
Work that is committed and actively being prepared.
This might cover the current release and the next one.
Items should be reasonably well understood, scoped and connected to a measurable outcome.
Next
Priorities that are likely to follow but can still change based on evidence.
These may require research, design, technical discovery or validation.
Later
Strategic themes, opportunities and larger bets.
Instead of promising exact features, use broader outcomes.
For example:
Weak:
"Add AI recommendation engine in March."
Better:
"Improve content discovery and personalization."
The second statement leaves room to test whether an AI recommendation engine is actually the best solution.

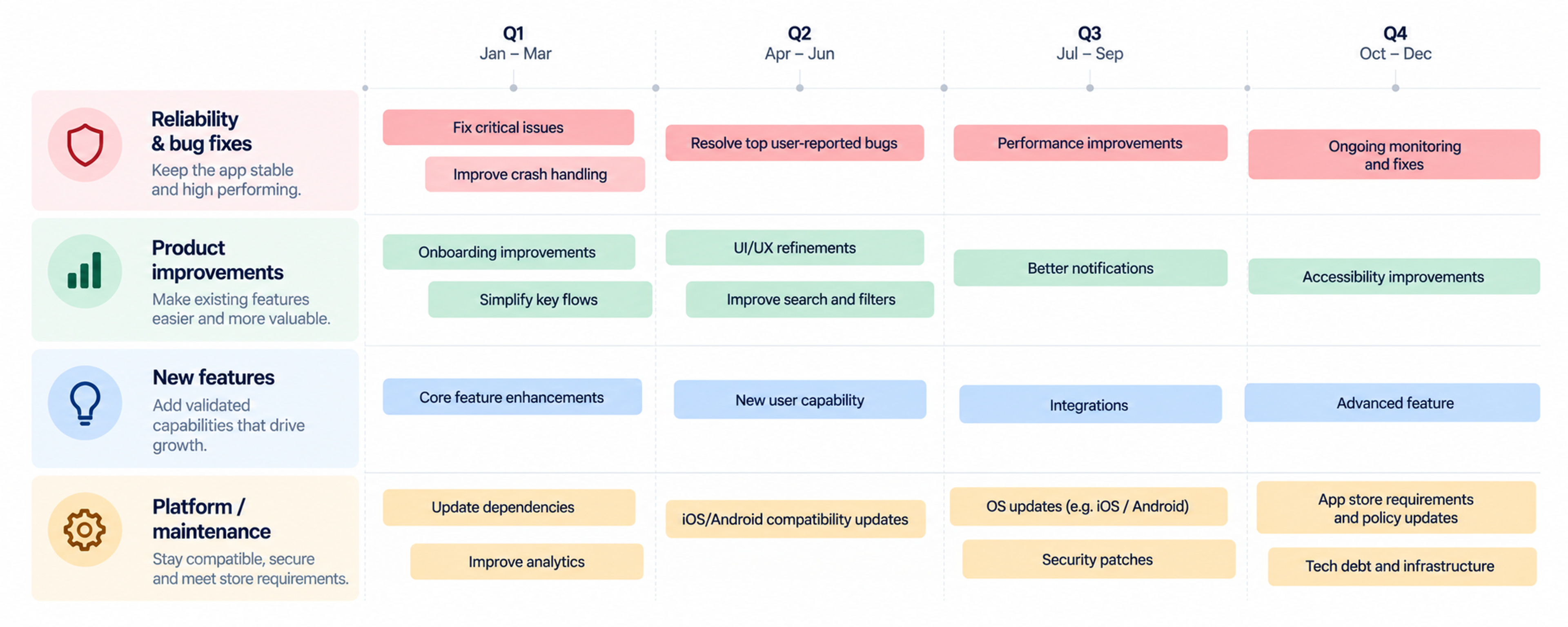

Mobile app update roadmap divided into Now, Next and Later planning horizons.
Suggested File Name: Tie every major update to an outcome
"Add saved searches" is a feature.
"Help returning users resume product discovery faster" is an outcome.
This difference matters because feature roadmaps can become self-fulfilling. Once the roadmap says a particular feature will be built, teams tend to measure success by whether it shipped.
An outcome-based roadmap asks whether the release changed something meaningful.
Possible app outcomes include:
reducing onboarding abandonment, increasing successful purchases, improving seven-day retention, decreasing crash rate, reducing support requests, increasing completed bookings, or improving repeat usage of a core workflow.
The metric does not have to be a single company-wide KPI.
It should simply match the problem.
For a crash fix, success may be lower crash incidence.
For onboarding, activation and retention may matter.
For a checkout redesign, completed transactions may matter.
Apple's analytics tools support version-level analysis for metrics such as usage, crashes and retention, making it possible to compare behavior around an update rather than simply assuming the new version helped. Apple Developer
Give bug fixes and technical debt permanent roadmap capacity
Teams sometimes create a roadmap in which every sprint is allocated to planned feature work and then treat bugs as interruptions.
That structure guarantees conflict.
Production software will generate unexpected work.
Dependencies will need updating.
Devices will behave differently.
An external API will change.
A new OS version will expose an edge case.
Rather than pretending this work will not occur, reserve capacity for it.
You do not need to use a universal fixed percentage because the correct allocation depends on product maturity, technical condition and release risk.
A recently launched app may require more stabilization work.
A mature app with a healthy architecture may spend more capacity on incremental product improvements.
An older app with neglected dependencies may need a temporary maintenance-heavy cycle.
The important point is to make this work visible.
If maintenance remains invisible, stakeholders see only that feature delivery is "slower than planned."
Use customer feedback without letting customers design the roadmap
Users are good at explaining their problems.
They are not always the best people to specify the solution.
Suppose users repeatedly ask for an "Export to Excel" button.
The underlying problem might actually be that they need to share weekly reporting with managers.
A direct export may solve that.
But an automated report, dashboard or integration might solve it better.
Roadmap planning should therefore capture feedback in problem form.
Instead of logging:
"User wants dark mode."
Consider:
"Users who frequently work at night report eye strain and difficulty using the current interface."
That framing gives the product team room to investigate.
The same approach helps consolidate apparently different requests.
Ten feature requests may represent two underlying user problems.
Treat app reviews as signals, not requirements
Public reviews are valuable because they expose frustration in the language customers naturally use.
They can reveal:
recurring bugs, confusing updates, missing capabilities, perceived performance problems and expectations created by competitors.
But reviews are biased toward users motivated enough to leave them.
Do not count one-star reviews and automatically turn the largest category into the roadmap.
Combine them with support data, analytics and interviews.
The same applies to feature voting.
Popularity indicates interest, not necessarily business value or technical feasibility.
Use analytics to find friction before asking what to build next
A team planning updates often asks:
"What feature should we add?"
A more useful question is:
"Where does the existing product fail to deliver its intended value?"
Consider a subscription fitness app.
If many users install it but leave during onboarding, building a social feature may not solve the most important problem.
The roadmap should first investigate activation.
Apple specifically recommends using retention data to understand whether users continue engaging and suggests reviewing onboarding when retention is weak. Apple Developer
Similarly, a commerce app with strong browsing but weak checkout completion should investigate checkout before investing heavily in discovery features.
Post-launch analytics gives you something the original product roadmap did not have: evidence about where value is leaking.
Plan platform updates before they become emergencies
Mobile apps depend heavily on Apple and Google platform cycles.
That means platform planning should be visible on the roadmap.
For Android, this includes target API upgrades, permission changes, background execution behavior, new form factors and dependency compatibility.
As of August 31, 2026, new Google Play apps and app updates generally need to target Android 16, API level 36. Google advises developers to start migration work at least three months before relevant deadlines when possible. Google Help
Waiting until the submission deadline turns predictable maintenance into emergency work.
For iOS, teams similarly need to plan around Xcode, SDK and OS changes, device support and App Store requirements.
A healthy roadmap should therefore contain platform readiness work even if customers never explicitly request it.
Design smaller releases that are easier to evaluate
Large releases create measurement problems.
If an update includes a redesigned onboarding flow, new pricing, revised navigation, three new features and a new recommendation algorithm, what caused the change in retention?
You may not know.
Smaller releases make cause and effect easier to understand.
They also reduce operational risk.
This does not mean every change needs its own store submission. Related work can be packaged together sensibly.
The important principle is to avoid combining so many independent changes that the release becomes impossible to diagnose.
Feature flags can also help.
A capability may ship in the app but remain disabled until the team is ready to expose it to specific users.
This lets teams separate code deployment from feature release and creates more control over experimentation and rollback.
Beta test meaningful changes before broad release
A roadmap should include validation before production, not simply a development completion date.
For iOS, Apple's TestFlight supports beta distribution before public release and can be used to collect feedback from testers. Apple says developers can invite up to 10,000 external testers. Apple Developer
Google Play supports internal, closed and open testing tracks. Internal testing supports up to 100 testers for fast QA, while closed and open tracks allow broader testing before production. Google Help
Different updates need different testing depth.
A copy change may need little external testing.
A payment-flow rewrite deserves far more.
A database migration, authentication change or offline synchronization feature may require explicit failure testing rather than ordinary happy-path QA.
The release plan should reflect the risk of the change.
Use staged releases for high-impact updates
Even strong testing cannot reproduce every production environment.
Devices vary.
Operating systems vary.
Accounts have different histories.
Users follow workflows nobody anticipated.
For meaningful updates, gradual deployment reduces the blast radius of a problem.
Google Play staged rollouts allow a production update to be released to a percentage of users and expanded over time. A rollout can be halted if a problem appears. Google Help
Apple offers phased release for eligible updates over seven days. The standard sequence begins at 1% of users with automatic updates, then moves through 2%, 5%, 10%, 20%, 50% and finally 100%. Apple also allows a phased release to be paused for up to 30 days. Apple Developer
This is especially useful for releases involving:
authentication, payments, data migration, backend protocol changes, core navigation or other high-impact workflows.
A rollout strategy should be part of roadmap planning, not something decided after development finishes.
Define release gates before shipping
Every meaningful update should have explicit conditions that must be satisfied before broad rollout.
These gates will vary by app, but they may include:
- critical automated tests passing
- no unresolved blocker-level defects
- required analytics events verified
- accessibility checks completed
- migration paths tested
- crash-free beta behavior within expectations
- backend capacity confirmed
- app store metadata prepared
- support team briefed on major changes
- rollback or mitigation plan documented
This helps prevent release decisions from becoming emotional at the end of a sprint.
When launch day arrives, the team should already know what would stop the release.
Add a post-release observation window
Shipping is not the final task on the release checklist.
After release, monitor the version closely.
Look for changes in:
crash rate, ANRs, app startup, support contacts, login success, transaction failures, retention and any metric related specifically to the update.
Apple App Store Connect can filter usage data by app version, which can help identify regressions after releases. Apple Developer
For Android, Play Console's vitals provide stability information including crash metrics. Android Developers
The length of the observation period depends on usage patterns.
A daily-use messaging app may reveal problems quickly.
A tax app used heavily once a month may require longer observation.
Do not declare an update successful simply because it did not trigger immediate complaints.
Build the roadmap around dependencies
Features do not exist independently.
A seemingly simple update may depend on backend work, database changes, analytics, design, legal review, third-party APIs or infrastructure.
If those dependencies are discovered only when development begins, the roadmap becomes unreliable.
Before committing a significant item, identify its dependency chain.
For example:
A loyalty feature may require account identity improvements first.
A personalized home screen may require better event tracking.
Offline support may require synchronization architecture before interface work begins.
A new payment option may require backend, compliance and reconciliation changes.
Roadmapping should expose these prerequisites.
Sometimes the most important feature for the next quarter is actually infrastructure that enables three later features.
Treat backend and mobile releases as one product system
A mobile roadmap should not be planned in isolation from backend systems.
One of the harder post-launch problems occurs when app versions remain installed for months.
Unlike a website, where server-side changes reach everyone immediately, mobile users may continue running older versions.
Your backend may therefore need to support several app versions simultaneously.
This affects API changes.
Avoid changing or removing an endpoint in a way that immediately breaks older clients.
Use compatible API evolution, versioning or controlled minimum-version policies where appropriate.
This is especially important for authentication, payments and critical data synchronization.
Mobile roadmap planning needs to account for the lag between releasing a new app version and having the entire active user base adopt it.
Decide when an update needs migration planning
Some releases change data structures rather than just screens.
Examples include:
local database schemas, authentication systems, subscription models, encrypted storage, account structures or cloud synchronization.
Those updates deserve explicit migration work.
Ask:
What happens to existing users?
Can the migration fail halfway through?
Can data be recovered?
Can the user downgrade?
Does the backend still understand the old schema?
Can support identify which migration state a user is in?
If the update modifies persistent user data, the roadmap should treat migration as a feature in its own right.

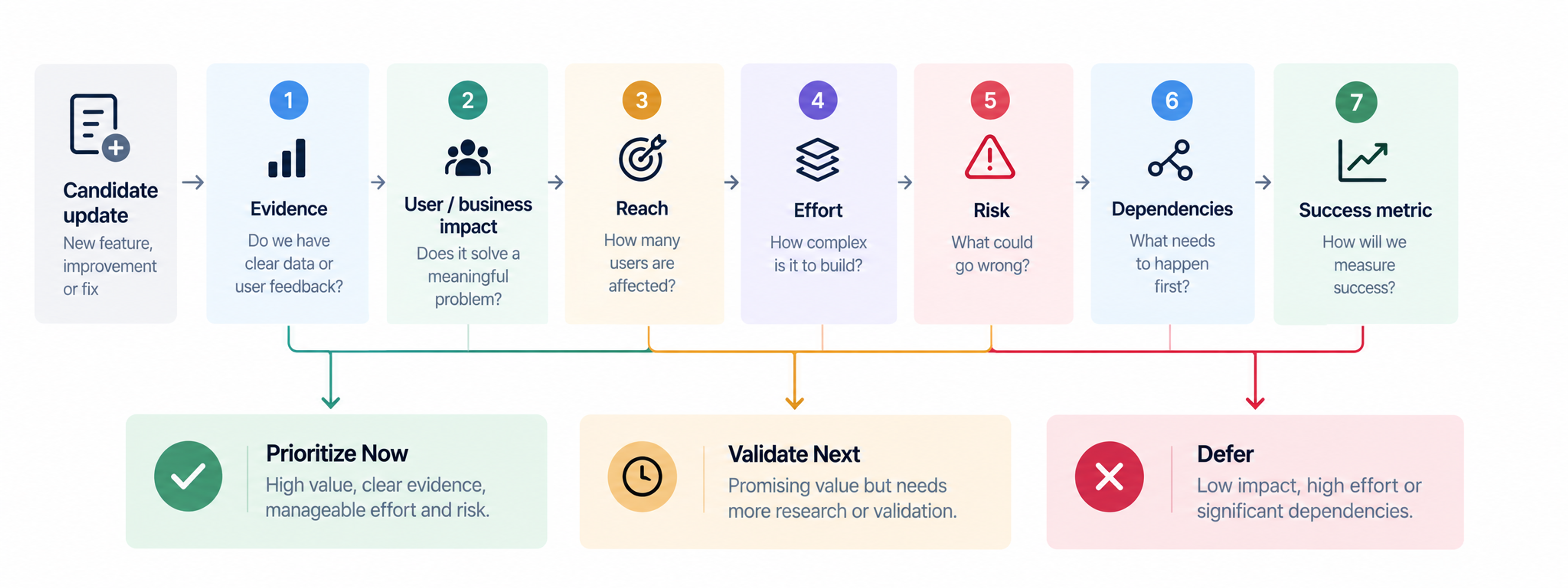

Use a simple roadmap scoring process
You do not need a complex product-management platform to plan intelligently.
For each candidate update, capture a few pieces of information:
Problem: What user, business or technical problem are we solving?
Evidence: What demonstrates that the problem exists?
Impact: What should improve if we solve it?
Reach: How much of the relevant user base is affected?
Effort: Roughly how expensive or complex is the change?
Risk: What can go wrong?
Dependencies: What must happen first?
Metric: How will we know whether it worked?
That creates much better roadmap discussions than a list containing only feature names and deadlines.
Plan around release themes, not arbitrary feature bundles
A strong release often has a coherent reason to exist.
For example:
Reliability release
Crash reduction, login fixes, dependency updates and performance improvements.
Activation release
Simpler registration, onboarding improvements and better first-use guidance.
Commerce release
Checkout improvement, new payment option and clearer order status.
Retention release
Saved content, reminders and improved re-engagement.
A theme gives the release focus and makes its results easier to communicate and measure.
It also helps prevent scope creep.
If a requested feature does not support the objective of the upcoming release, it can move to another cycle.
Keep roadmap dates appropriately uncertain
Executives and clients often want exact delivery dates.
Engineering teams often know those dates are unreliable months in advance.
The solution is not to eliminate timelines entirely.
It is to represent uncertainty honestly.
Committed near-term releases can have dates.
Mid-term priorities may use months or quarters.
Longer-term themes may have no exact date until discovery is complete.
This avoids one of the most damaging roadmap patterns: publishing precise dates for work that has not yet been researched, designed or technically evaluated.
A roadmap should increase confidence, not manufacture it.
Revisit the roadmap on a fixed cadence
A roadmap should change when evidence changes.
But if it changes every time somebody has a new idea, it stops being useful.
Use a predictable review cadence.
Operational issues may be triaged continuously.
Release planning might happen every few weeks.
Broader roadmap review may happen monthly or quarterly depending on the business.
During review, ask:
What changed in user behavior?
What did the last release teach us?
Which assumptions were wrong?
What new platform requirements appeared?
Has a technical dependency changed?
Did a planned feature become less important?
Which unresolved reliability problems are accumulating?
The goal is not to rewrite the strategy every month.
It is to keep the plan connected to reality.
Common post-launch roadmap mistakes
Building the entire original backlog
Pre-launch ideas should not automatically survive contact with real users.
Some assumptions will be wrong.
Delete ideas when evidence no longer supports them.
Measuring releases by output
"Shipped five features" is not a product outcome.
Measure whether behavior, reliability or business performance improved.
Ignoring maintenance until something breaks
Platform and dependency work is predictable.
Put it on the roadmap before it becomes urgent.
Letting the loudest customer control priorities
Customer feedback is evidence, not an automatic instruction.
Look for patterns and underlying problems.
Shipping large releases with no rollout control
Large changes increase risk and make regressions harder to diagnose.
Use beta testing, feature flags and phased rollout where appropriate.
Treating analytics as an afterthought
If you ship a major workflow without the events needed to evaluate it, the roadmap loses one of its most valuable feedback mechanisms.
Instrumentation should be part of the feature scope.
Never removing features
Roadmaps do not only add things.
Low-value features increase interface complexity, testing effort and maintenance cost.
Sometimes the right update removes functionality.
What a healthy 12-month roadmap might look like
A useful annual roadmap is balanced rather than overloaded.
The first period after launch may emphasize stability, analytics and onboarding because the team is still learning how the product behaves in production.
The next period can focus on improving the strongest core workflow.
Later cycles can introduce new capabilities once the foundations are reliable.
Meanwhile, maintenance continues throughout.
For example:
First phase: stabilize critical flows, resolve major defects, improve analytics coverage and establish baseline retention.
Second phase: improve onboarding and activation based on observed friction.
Third phase: build one validated high-value capability and improve existing core workflows.
Fourth phase: tackle strategic expansion while completing platform upgrades and accumulated maintenance.
The exact sequence will differ for every application.
The principle is that the roadmap should mature alongside the product.
Early-stage apps need learning and stabilization.
Mature apps need optimization, platform health and selective expansion.
The roadmap should become more evidence-driven after every release
The strongest post-launch roadmaps are not the longest or most detailed.
They are the ones that improve as the team learns.
Each release should generate information about product behavior, technical health and user needs. That information should influence what happens next.

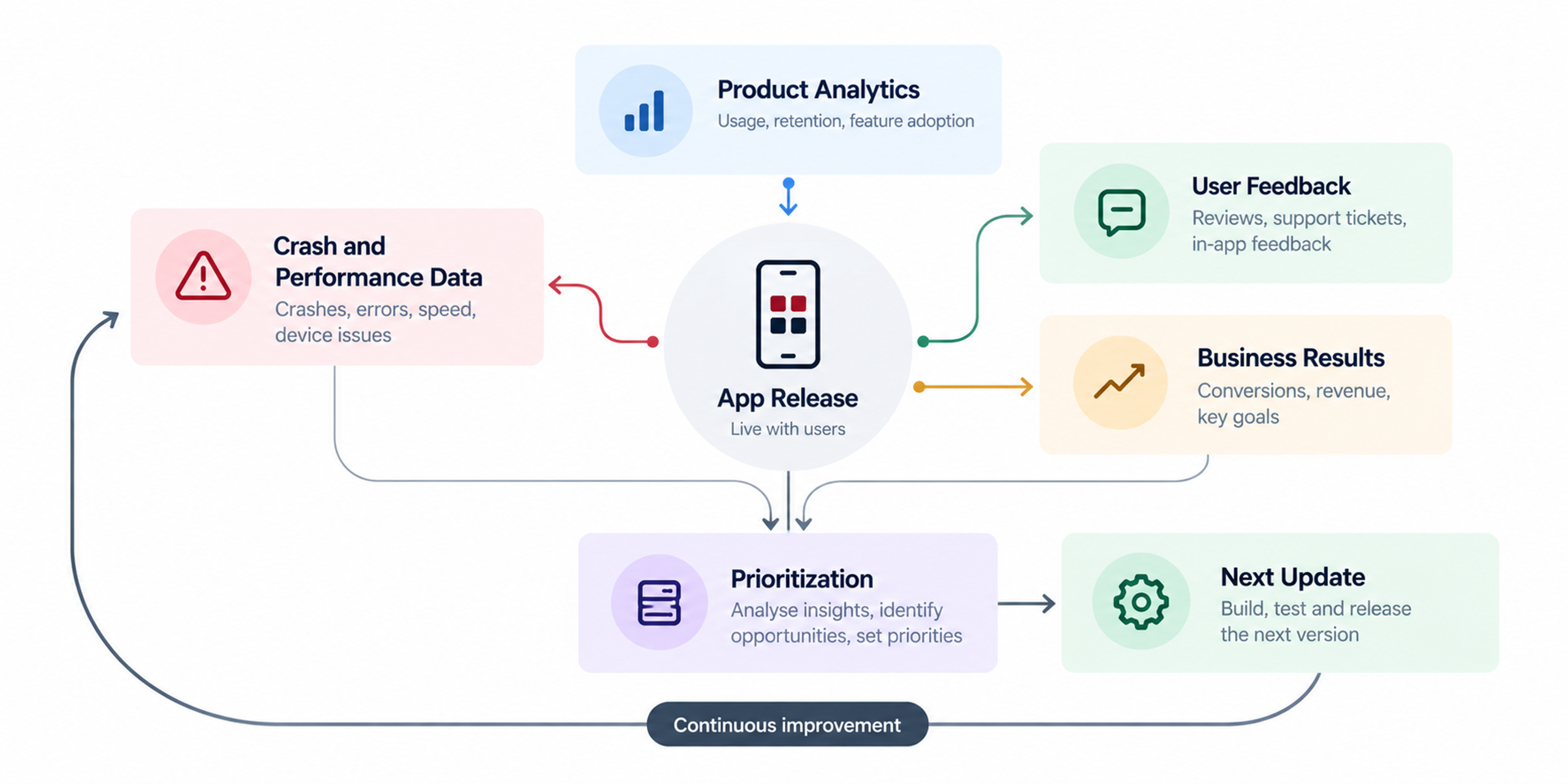

This creates a cycle:
ship, observe, learn, prioritize, improve.
The product still needs direction. Teams should not blindly follow analytics or build every customer request.
But once the app is live, planning should become progressively less dependent on assumptions.
The roadmap should balance what users want, what the business needs, what the technology requires and what the team can safely deliver.
When those four things are managed together, post-launch development stops being a sequence of reactive updates.
It becomes a disciplined process for making the app more useful, reliable and sustainable with every release.
Frequently Asked Questions
There is no universal update frequency. Release when there is enough validated value or necessary maintenance to justify an update. Critical bugs may require immediate releases, while larger features may follow a slower cycle. A predictable development cadence is useful, but teams should not publish unnecessary updates simply to meet an arbitrary schedule.
A complete roadmap should include bugs and reliability work, improvements to existing workflows, validated new features, technical debt, dependency updates, security work, operating-system compatibility and app-store requirements.
Start with the problem behind the request. Look for evidence in analytics, interviews, support data and business needs. Then consider impact, reach, effort, risk and dependencies before committing the solution.
No. Small, low-risk changes may not need one. Phased or staged rollout is particularly useful for significant changes where a regression could affect many users, such as payment, authentication, migration or core workflow updates.
Define the success metric before development. Then compare relevant metrics after release, such as retention, completion rate, crashes, conversions, support volume or usage of the improved workflow. Avoid declaring success merely because the feature shipped.
Critical bugs should take priority. Lower-severity defects can be weighed against feature value, customer impact and strategic goals. The roadmap should maintain capacity for both rather than allowing feature development to consume everything.
Near-term releases can be detailed. Mid-term planning should be less specific, and long-term planning should focus on outcomes or themes. The further into the future the roadmap goes, the more uncertainty it should show.
