A SaaS roadmap for a brand-new product is a different document from the roadmap of an established one. Mature products plan around backlogs, quarterly targets, and competing stakeholder requests. A product in its first two years is still answering a more basic question: does anyone need this enough to keep paying for it? The roadmap's job is to get you to that answer quickly, then help you build on it without spending your runway on things that don't matter.
That shift in purpose changes how you should plan. Instead of a long list of features with delivery dates, the first two years work better as a sequence of four phases, each with a clear outcome, each unlocking the next. What follows is a practical way to build that plan, including what to prioritize at each stage, which technical decisions are worth getting right early, and where teams most often lose months.
Why the First Two Years Deserve Their Own Plan
Early-stage SaaS companies rarely fail because the software doesn't work. They fail because they build the wrong thing, or build the right thing before they've proven it. CB Insights' 2024 analysis of failed venture-backed startups found that poor product-market fit was cited in 43 percent of cases. Startup Genome's research points in the same direction from a different angle, attributing roughly 70 percent of high-growth collapses to scaling before product-market fit was established.
The uncomfortable implication is that a detailed two-year feature schedule is often a liability. It commits you to building things in a fixed order before you know which of them matter. Data from ChartMogul reinforces how unforgiving the early period is: weak retention in the first three months usually signals problems with onboarding or with acquiring customers who were never a good fit, and only 13 percent of startups reach $10 million in ARR within ten years. Most of the difference between those who do and those who don't comes down to what they learned early and how fast they acted on it.
So the goal of a two-year roadmap isn't to predict what you'll ship in month nineteen. It's to define what you need to learn and prove in each phase, and to leave room to change course when the evidence says so.
Plan Around Outcomes, Then Choose Features
Before laying out the phases, it helps to settle how the roadmap itself will be written, because this choice shapes every conversation you'll have about it.
A feature roadmap lists things to build. An outcome roadmap lists changes you want to see in customer behavior or business results, and treats features as hypotheses about how to get there. The difference sounds subtle but has real consequences. ProductPlan's State of Product Management report found that 54 percent of product managers primarily track features and releases rather than outcomes, and that figure rises to 70 percent under executive pressure. That's how teams end up shipping fifteen features in a quarter while churn stays flat.
Here's what the difference looks like in practice. A feature-based quarter might read: build a team dashboard, add a CSV import, and launch a Slack integration. An outcome-based version of the same quarter reads: get new accounts to their first meaningful result within their first week, and reduce the number of accounts that go quiet after onboarding. The dashboard, import tool, and integration might still get built, but only if they serve those outcomes, and they can be swapped for something better if they don't.

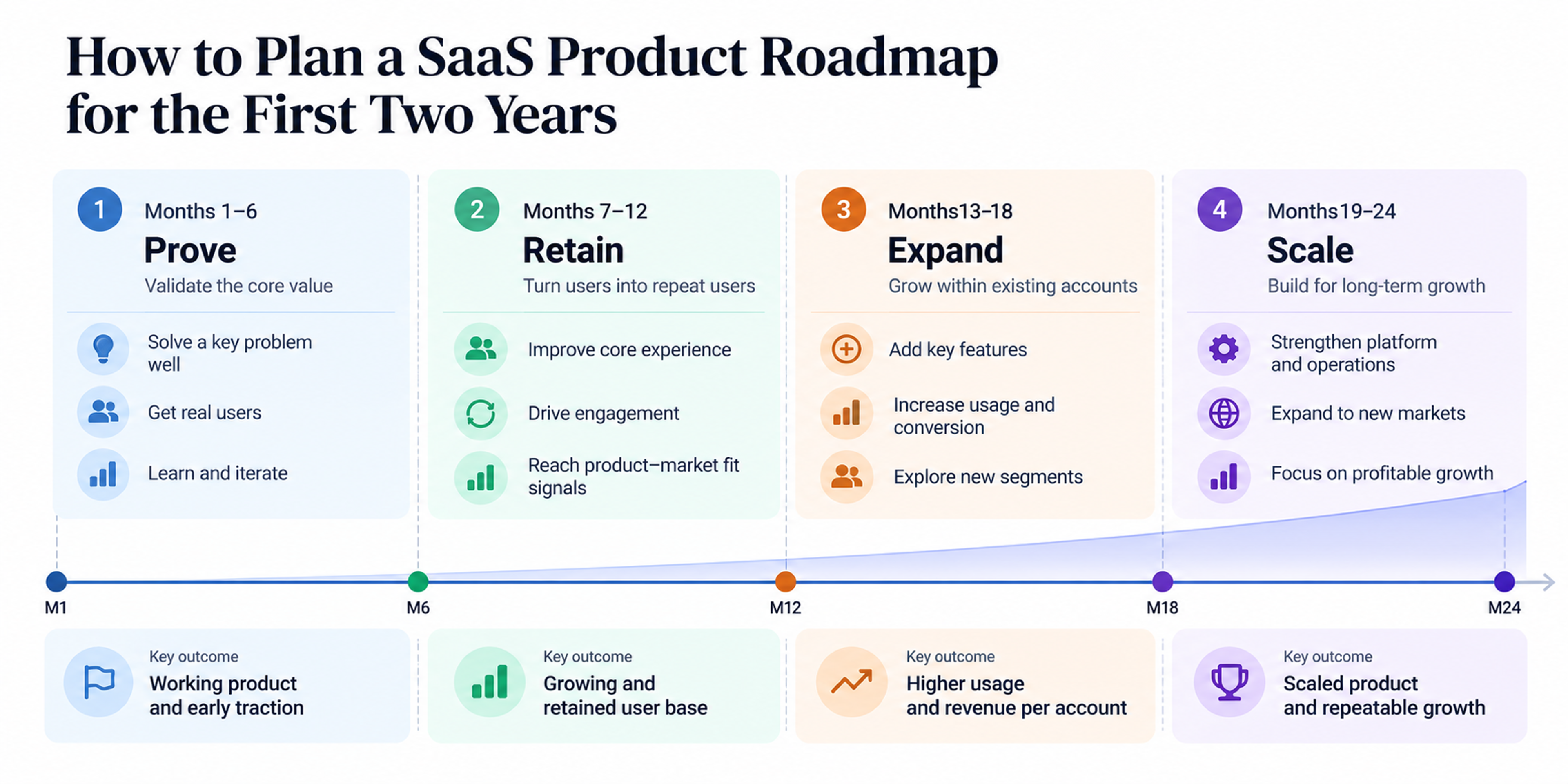

A "Now, Next, Later" format suits this approach well for the first two years. Now holds what the team is actively working on, Next holds what's likely to follow if current bets pay off, and Later holds ideas worth remembering but not committing to. Use firm dates sparingly, mainly for things with genuine external deadlines such as a contractual commitment or a compliance requirement. Putting a date on everything turns a roadmap into a project plan that needs constant rescheduling, and it quietly invites the sales team to promise dates to prospects that engineering never agreed to.
Months 0 to 6: Prove the Problem and Ship a Narrow First Version
The first phase has one question: is this problem painful enough that people will pay to solve it, and does your approach actually solve it?
Validate before you build
Talk to potential customers before writing code, and keep talking to them throughout. Look for evidence of the problem in how people currently cope: spreadsheets held together with manual effort, expensive workarounds, tools they've bolted together that don't quite fit. If people describe the problem enthusiastically but have never tried to solve it, that's a weaker signal than people who already spend money or time on a clumsy fix.
Define the first version around one job
A first release should do one thing well for one type of customer. The temptation to add breadth is strong, especially in categories like CRM and ERP where buyers are used to large, all-in-one systems. Resist it. A narrow product that a specific type of customer loves gives you clean feedback. A broad product that partially serves five types of customers gives you noise.
Make the technical decisions that are expensive to reverse
Most of the technical choices in phase one can be changed later. A few can't, or can only be changed at great cost, and these deserve real attention now.
The data model is the first. How you structure accounts, users, and the relationships between them will shape everything, including reporting, permissions, and integrations. If your product will eventually serve organizations with teams, departments, or multiple locations, model that possibility early, even if you don't build the interface for it yet.
Multi-tenancy is the second. Serious SaaS products serve many customers from shared infrastructure while keeping each customer's data isolated. Decide how you'll handle that separation before you have customer data to migrate.
Third, plan for an API from the start. Even if you never expose it publicly in the first year, building your own interface on top of a clean API makes later integrations far easier. This matters especially for CRM, ERP, and workflow products, where customers will expect the tool to connect to accounting software, email, and other systems they already use.
On architecture more broadly, most guidance for early products recommends starting with a well-organized monolithic backend on a managed cloud platform, rather than splitting into many services from the start. Microservices solve problems that a two-person engineering team doesn't have yet.
The outcome to aim for by month six: a working product in the hands of a small group of real customers, and enough usage data to tell whether they come back.
Months 6 to 12: Fix Activation and Retention Before Adding Breadth
This is the phase most roadmaps skip past, and it's often where the company's fate is decided. Getting users in the door is not the same as getting them to stay.

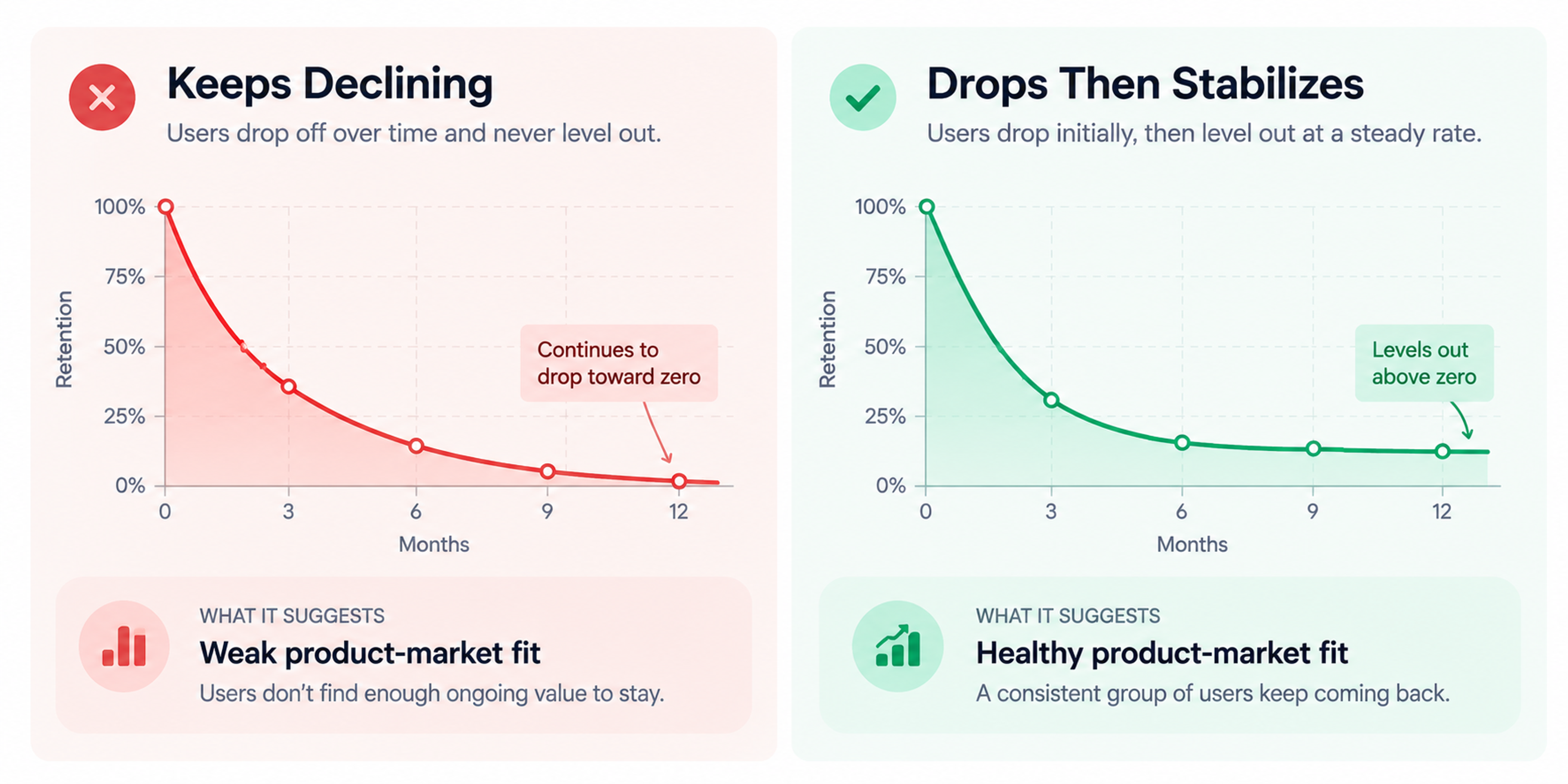

Start by measuring what actually happens after signup. What percentage of new accounts complete the first meaningful action? How long does it take? Where do people stop? ChartMogul's retention data shows that the first few months tend to follow a steep decay curve, and that net retention typically weakens further in year two as churn rises and expansion revenue falls. Understanding your own curve early is far more useful than comparing yourself to an industry average.
Benchmarks can help, with caveats. For B2B SaaS, monthly churn below 2 percent combined with net revenue retention above 100 percent is often cited as the financial signature of product-market fit, and median annual customer retention for B2B SaaS sits somewhere around 88 to 90 percent. But these vary enormously by segment. SMB-focused SaaS with smaller contract values commonly tolerates monthly churn of 3 to 5 percent, while enterprise products are expected to retain far more. Compare yourself to companies selling to similar customers at similar price points, not to a blended average.
A useful qualitative check alongside the numbers is the Sean Ellis test: ask active users how they would feel if they could no longer use the product. If fewer than 40 percent say they'd be very disappointed, the product probably isn't ready for heavy investment in growth, no matter how good the top-of-funnel numbers look.
During this phase, the roadmap should be dominated by work on onboarding, the core workflow's rough edges, and instrumentation, meaning the ability to see what users actually do. Teams often discover in month eight that they can't answer basic questions about usage because nobody built the tracking. It's far cheaper to add it now.
The outcome to aim for by month twelve: a retention curve that flattens, a clear picture of who your best customers are, and a first pricing structure informed by what customers actually value rather than a guess.
Months 12 to 18: Build for the Customers You Actually Have
With early signals of fit, the roadmap can widen. But widen deliberately, guided by what your retained customers keep asking for and what stops prospects from buying.
Expansion revenue becomes a major theme here. A net revenue retention figure above 100 percent means existing customers generate more revenue than you lose to churn, which is one of the healthiest positions a SaaS business can be in. Features that support expansion include seat-based or usage-based growth, additional modules, and capabilities that larger teams within the same customer need.
Integrations typically rise in importance during this phase. As customers embed your product into daily operations, they'll want it connected to the rest of their tools. For a CRM, that might mean email, calendar, and marketing platforms. For an ERP or operations product, it usually means accounting systems, payment processors, and data import from whatever they used before. Integration requests are among the most reliable signals of real adoption, because nobody asks to connect a product they don't intend to keep using.
If you're beginning to sell to larger organizations, expect a new category of requirements: single sign-on, granular roles and permissions, audit logs, data export, and security documentation for procurement reviews. These aren't exciting to build, but larger buyers often treat them as prerequisites, and discovering this mid-deal is painful. Add them to the roadmap once you have evidence that larger customers are coming, not before.
The outcome to aim for by month eighteen: net revenue retention trending toward or above 100 percent, a small set of integrations that customers actually use, and a clear understanding of which customer segment to focus on as you grow.
Months 18 to 24: Scale Deliberately and Pay Down What You Deferred
By now the product has real customers, real revenue, and real accumulated shortcuts. The final phase of the first two years is about strengthening the foundation so that growth doesn't break things.
Product consultants describe a recurring pattern in which teams that ship quickly without investing in platform work end up spending more time fighting their architecture than advancing the product within 18 to 24 months. Whether or not it happens on that exact schedule, the underlying dynamic is familiar to anyone who has watched a codebase age. Performance problems, brittle integrations, and messy data all get worse as usage grows.
This is the point to give platform work a permanent, protected place on the roadmap. A reasonable starting point is to reserve a meaningful slice of each cycle for reliability, performance, security, and cleanup, and to treat that allocation as fixed rather than the first thing cut when a deadline tightens. The exact percentage depends on your situation, but the principle matters more than the number: platform work that is always deferred eventually stops being optional.
This is also when packaging and pricing deserve a second look. Plans that made sense for your first twenty customers often need adjusting once you understand which features drive value for which segments.
Be careful about scaling too early in other ways. Hiring aggressively, expanding to new markets, or launching a second product before the first has proven its retention is exactly the pattern Startup Genome's research associates with failure. Scale what's working. Don't scale what you hope will work.
The outcome to aim for by month twenty-four: a product that can handle two to three times its current load without drama, a roadmap process that a growing team can follow, and a clear view of what the next two years should prove.
Prioritizing Without Turning the Roadmap Into a Wishlist
Every product team feels pressure from three directions: customers who want specific features, sales who want to close deals, and leadership who want visible progress. Without a clear method, whoever argues loudest wins.

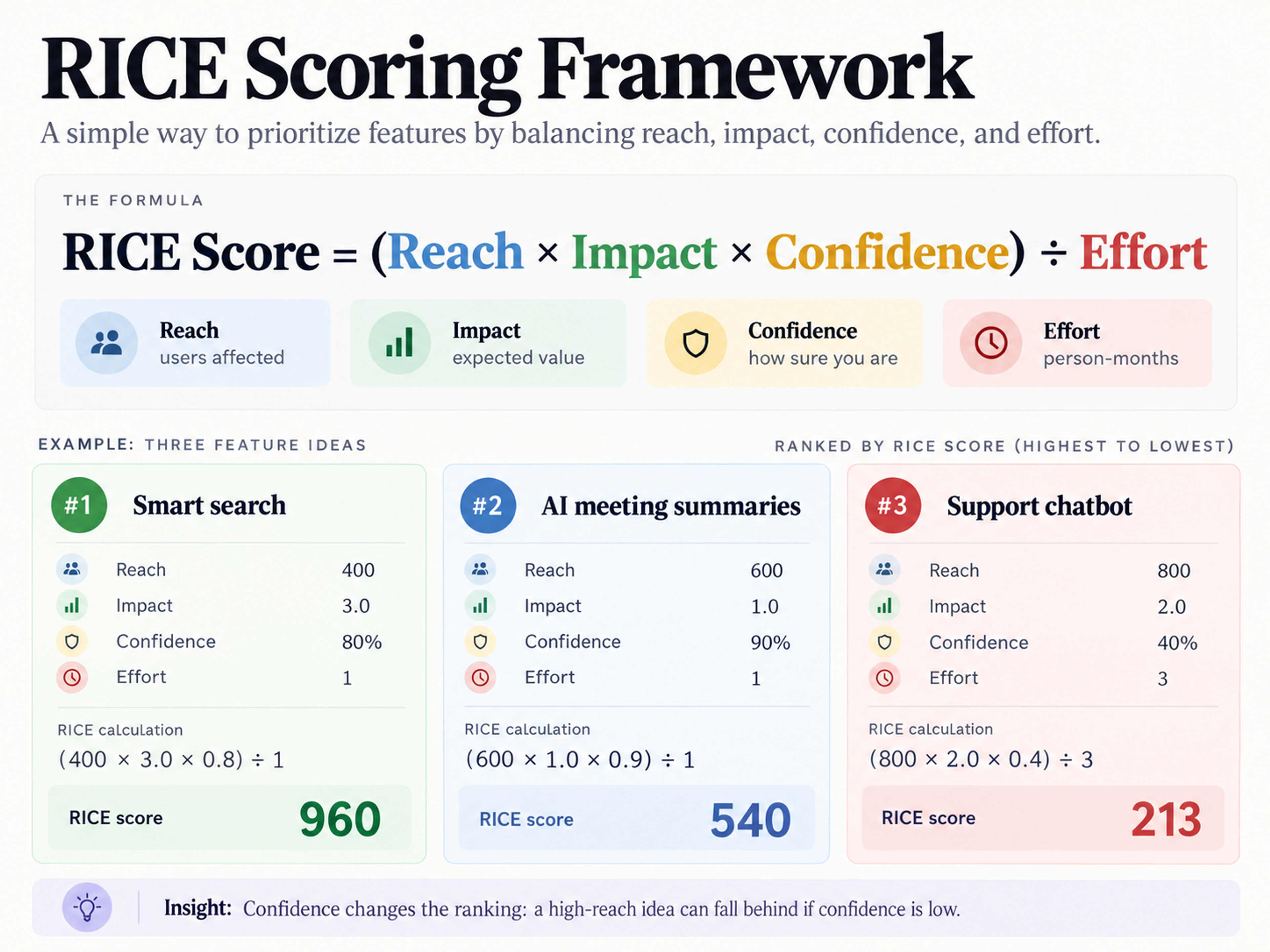

A simple scoring framework such as RICE, which weighs reach, impact, confidence, and effort, gives the conversation a shared vocabulary. It won't produce perfect answers, but it forces people to state their assumptions, and it makes it easier to say no without it feeling personal. Confidence is the most useful part of the score in the early years, because it makes teams admit when an idea rests on a hunch rather than evidence.
Two habits protect the roadmap. First, treat feature requests as evidence of a problem, not as specifications. A customer asking for a specific report is telling you they can't get some information they need, and the best solution might look nothing like what they described. Second, be willing to decline requests that don't fit the current outcomes, even from large customers. A product that bends to every request gradually becomes a custom project for each buyer, which is the opposite of scalable software.
Where CRM and ERP Products Differ
Products in the CRM and ERP space tend to face a few extra constraints worth planning around. They are data-heavy and workflow-heavy, which means switching costs are high for customers, and adoption depends on how smoothly data moves in from existing systems. A CRM that takes three months to migrate into is a harder sell than one that imports in an afternoon, so migration tooling deserves an earlier place on the roadmap than it might for other kinds of SaaS.
These products also tend to face pressure toward customization. Customers want fields, workflows, and reports that match how they operate. The trap is building bespoke options for each customer. A better approach is to invest in configurability, letting customers adapt the product themselves within sensible limits, so your engineering team isn't the bottleneck for every variation.
Common Mistakes in the First Two Years
The most damaging mistake is treating the roadmap as a promise instead of a plan. When dates on a roadmap become commitments to customers, teams lose the ability to respond to what they learn, and quality suffers when deadlines are defended against better information.
A close second is building for the customer you hope to have in year three. Enterprise features, elaborate permission systems, and extensive customization are worth building when enterprise customers are actually arriving, and rarely before.
Another common problem is skipping measurement. Teams that don't instrument the product can't tell which features get used, which is how roadmaps drift toward building things nobody touches.
Finally, avoid treating the roadmap as a one-time document. A quarterly review, comparing what you expected to happen with what did, keeps the plan honest. The best roadmaps in the first two years get revised often, and that's a sign of a team paying attention rather than a team without a plan.
Frequently Asked Questions
Detailed for the next three months, directional for the following six, and deliberately loose beyond that. Precision about the distant future is mostly false confidence.
Only if it serves a broader need among your target customers or fits your current outcomes. Building one-off features for individual buyers is one of the fastest ways to turn a product company into a consulting company.
Most early-stage teams benefit from a light monthly check and a deeper quarterly review. The goal is to compare results against the outcomes you set, not just to check progress against a schedule
A roadmap describes direction and intended outcomes over time. A backlog is the detailed list of specific tasks, bugs, and ideas the team could work on. The roadmap should guide what gets pulled from the backlog, not duplicate it.
Look for a retention curve that levels off above zero, strong reactions in surveys asking how users would feel if the product disappeared, and customers who come back and recommend you without prompting. No single number settles it, but these signals together are far more reliable than top-line signups.
