Software projects rarely fail because the code could not be written.
They fail because nobody agreed on what problem the software was meant to solve, because the scope kept growing, because the people paying and the people building stopped talking, or because the finished product was never something users wanted. The technology is usually the smaller part of the story.
That is good news, because the causes are well understood and most of them can be addressed before a single line of code is written. This guide walks through the most common reasons software and website projects fail, what the research actually says, how to spot trouble early, and what to do about each risk. It is written for business owners, product managers, and technical leads who commission or run projects, whether the work is done in-house or by an agency.
What "Failure" Means, and What the Numbers Say
Before looking at causes, it helps to be honest about the statistics, because failure rates are quoted loosely and often misused.
The best-known source is the Standish Group's CHAOS report. Its 2020 edition, as summarized in a project management textbook, indicated that 31% of projects were successful, 50% were challenged, and 19% failed. Those headline figures are widely repeated. They are also contested. Academic work by Eveleens and Verhoef, published in IEEE Software in 2010, challenged the Standish figures, partly because of how success and failure are defined. A project that finishes late or with fewer features than first planned gets filed as "challenged" even if the business is delighted with it, and an on-budget project that nobody uses counts as a success. Treat the percentages as a rough indication that many projects struggle, not as a precise measure.
A more rigorous study comes from McKinsey and the University of Oxford, who analyzed more than 5,400 large IT projects with initial budgets above 15 million dollars. They found that on average, large IT projects run 45 percent over budget and 7 percent over time, while delivering 56 percent less value than predicted. They also found that every additional year a project is scheduled to take increases cost overruns by 15 percent. That sample is skewed toward very large programs, so a small website build will not behave the same way. But the pattern, where duration and scale increase risk and where value shortfalls are common, applies at every size.
The Project Management Institute adds a useful perspective on cost. Its 2020 Pulse of the Profession report found that 11.4% of investment is wasted due to poor project performance.

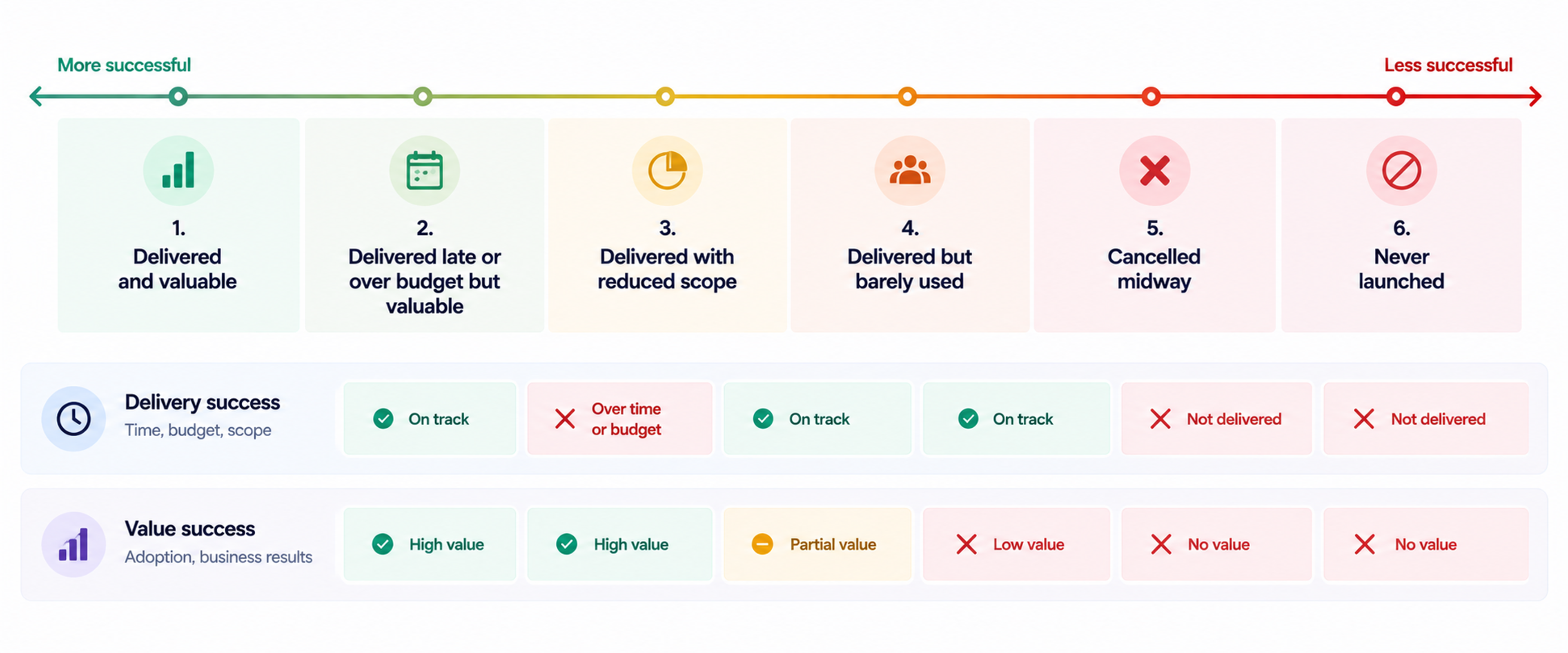

The practical lesson is to define failure for your own project at the start. It is not only "late" or "over budget." A project also fails if it delivers software that works but does not change the business outcome it was meant to change, or if it is delivered and then abandoned. Some projects are cancelled midway, and that can be the right decision when the facts change. The aim is to avoid wasting money on the wrong thing, not to avoid every adjustment.
Reason 1: No Clear Problem or Measurable Goal
The most fundamental cause is that the project starts without a sharp answer to a simple question: what problem are we solving, and how will we know it is solved? Teams begin with a solution in mind, such as "we need an app" or "we need a new CRM," and skip the harder work of defining the outcome.
The PMI's 2020 findings point at this directly. Among the factors it identified as responsible for project failure, the most common was a lack of clearly defined or achievable milestones and objectives to measure progress, cited in 37% of cases. Without objectives, there is no basis for deciding what to include, what to cut, or whether to proceed.
How to avoid it. Write a one-page problem statement before choosing a technology or a vendor. State who has the problem, what it costs them, and what changes if it is fixed. Define two or three measurable outcomes: reduce average order processing time from 12 minutes to 5, increase online bookings by a given percentage, cut support tickets about password resets in half. Add a short list of non-goals, things the project will deliberately not do. This protects the scope later. Revisit the statement at every major decision, and use it to say no.
Reason 2: Vague and Shifting Requirements
Once the goal is clear, the next trap is poor requirements. Requirements that are vague, incomplete, or understood differently by different people produce software that is technically correct and practically wrong. PMI research reported that nearly half, 47 percent, of unsuccessful projects fail to meet goals due to inaccurate requirements management. That study dates from 2013, so treat the figure as a long-standing pattern rather than current measurement, but practitioners continue to report the same problem.
Closely related is scope creep, the steady addition of features without matching changes to time or budget. It rarely arrives as one big request. It arrives as a series of reasonable-sounding additions: "Could we also let users export to PDF?" "Can the dashboard have one more filter?" Each is small, but together they change the project.
How to avoid it. Capture requirements as specific scenarios and acceptance criteria, not only feature names. "Users can reset their password" is vague. "A user who requests a reset receives an email within one minute with a link that expires after 30 minutes, and can set a new password that meets the policy" is testable. Use prototypes and wireframes early, since people react to something they can see far better than to a document. Prioritize ruthlessly, for example by sorting features into must have, should have, and could have, and agree what must be in the first release.

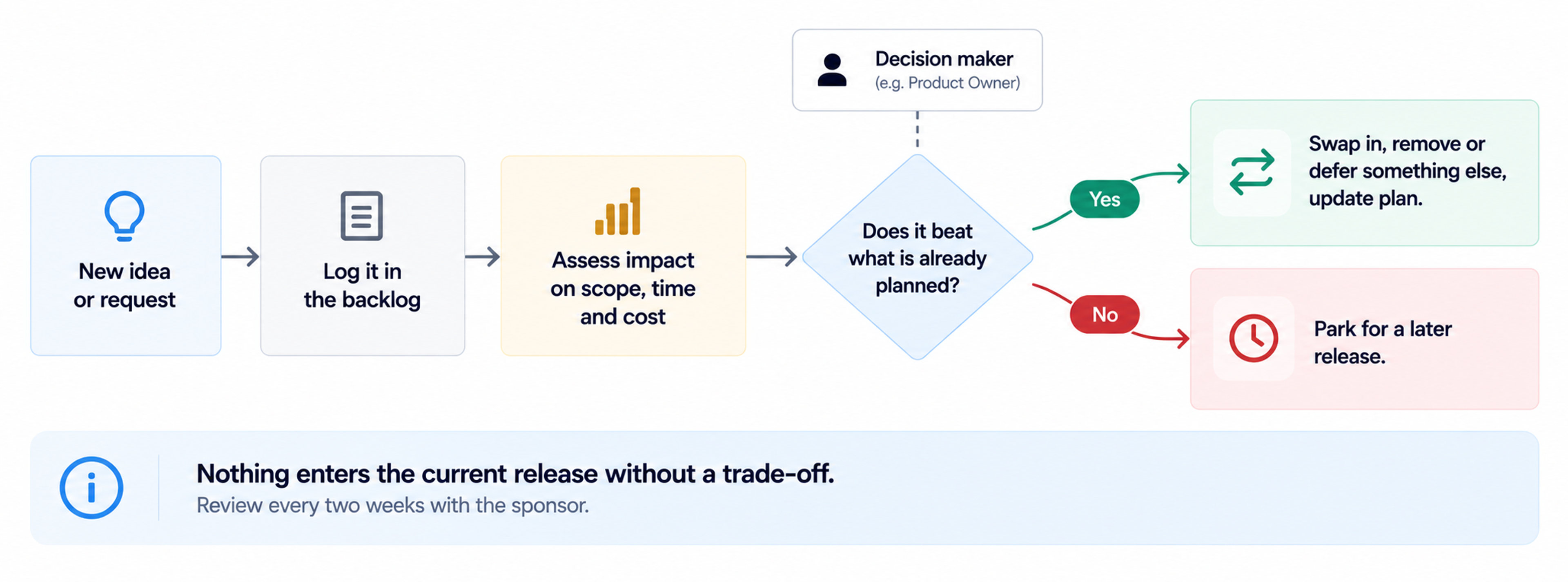

Then manage change on purpose. Changes are not forbidden, since learning is part of building software, but each one should be visible: what it adds, what it costs, what it displaces. A simple change process where a named person decides, and where the effect on time and cost is stated before approval, prevents unplanned growth.
Reason 3: Weak Communication and Absent Stakeholders
Many projects fail quietly through poor communication rather than dramatic technical errors. The PMI's 2020 data attributed a significant portion of failures to communication problems: poor communication in 19% of cases and lack of communication by senior management in 18%. Earlier PMI research that has been widely cited by project management practitioners placed communication even higher, which suggests it is a persistent issue across years.
In software projects, communication failures take a few familiar forms. The business side assumes the development team understands the context and the developers assume the business side has made decisions that have not actually been made. Questions sit unanswered for days. The people who will use the software are never consulted. The executive sponsor approves the project and then disappears until the launch.
How to avoid it. Name one accountable decision-maker on the business side, someone with the authority to answer questions and make trade-offs quickly. Waiting for a committee to respond to each question is one of the biggest sources of delay. Establish a regular cadence: a short weekly check-in, a demo of working software every one or two weeks, and a clear channel for questions. Demos matter because they replace reports about progress with evidence of progress. Involve real users throughout, not just at the end. Make bad news welcome by agreeing that early warnings are rewarded, since problems discovered in week three cost far less than problems discovered in month six.
Reason 4: Unrealistic Estimates and Plans
Software estimation is hard, and optimism makes it worse. Teams estimate best-case scenarios, forget integration, testing, review cycles, and holidays, and then treat the estimate as a promise. Clients, understandably, want a single number and date, which pushes everyone toward false precision.
The McKinsey and Oxford finding that duration is correlated with overrun is a reminder that long plans carry compounding uncertainty. The more that has to go right over a longer period, the more likely something will not.
How to avoid it. Ask for estimates as ranges with stated assumptions, such as "eight to twelve weeks, assuming the payment provider's API works as documented and design approval within three days." Compare the estimate with similar past projects, since a team's own history is more reliable than its intuition. Add explicit buffers for the unknown and make them visible instead of padding every task silently. Break large projects into smaller phases with their own estimates and decision points, so you learn the team's actual speed early and adjust. Be wary of any proposal that is much cheaper or faster than the others without a clear reason, because the difference often reappears later as change requests or missing work.
Reason 5: Building Too Much Before Learning Anything
A common pattern is the big-bang project. Requirements are gathered upfront, the team disappears for many months, and a complete product is unveiled at the end. By then, the market, the business, and the users' needs may have moved, and assumptions that went untested for half a year turn out to be wrong.
The risk is especially high for new products and features, where nobody can be sure what users will actually do. It is also expensive, because every wrong assumption is baked into a large amount of finished work.

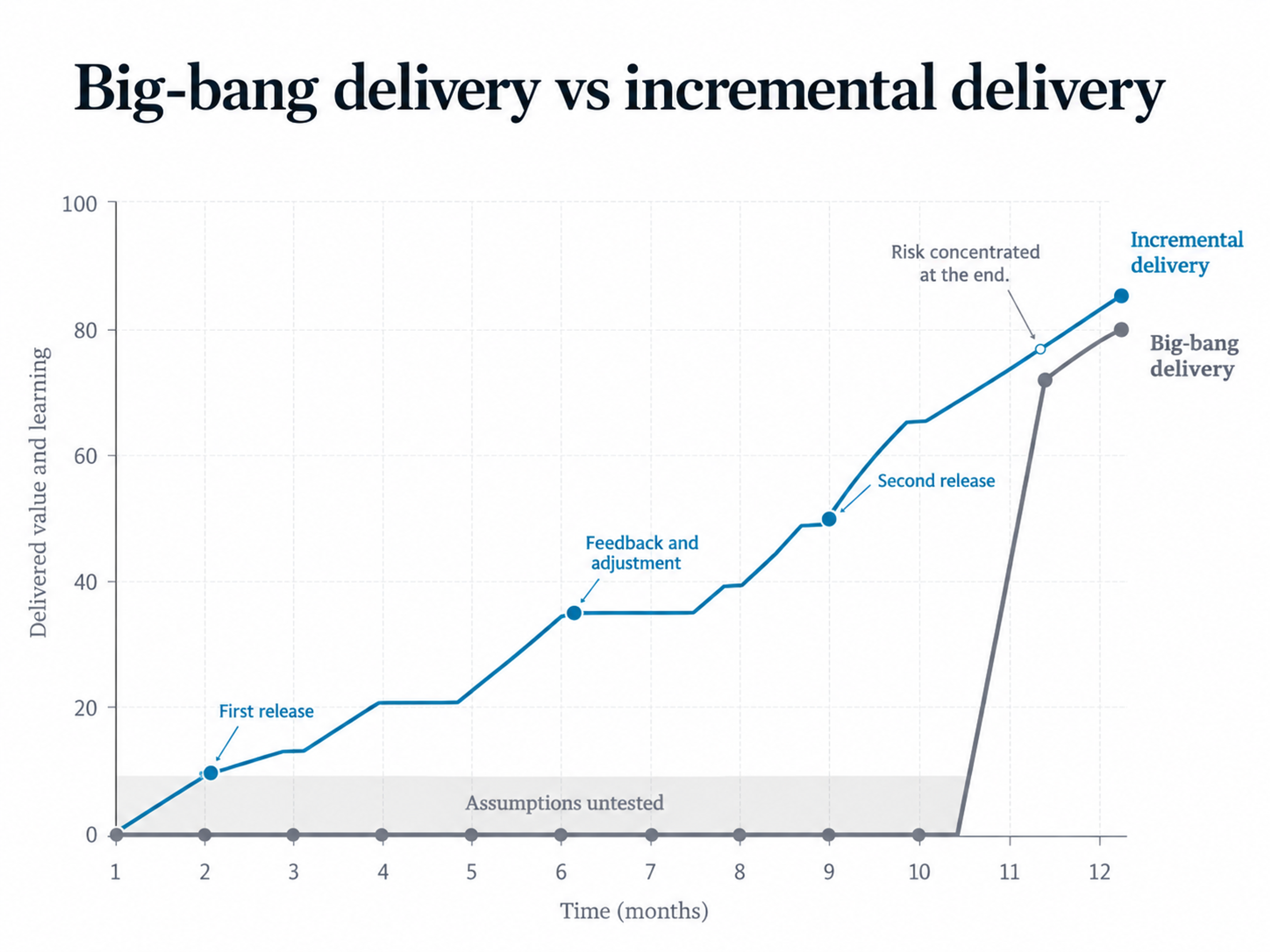

How to avoid it. Deliver in thin slices that go all the way through the system and can be used by someone. A minimum viable product is the smallest version that tests the core assumption: will people use this, and does it solve the problem? Release it to a small group, learn, and then expand. Use pilots for internal systems: roll out to one team or one location first. Feature flags, which let you switch functionality on for selected users, make staged release safer.
This does not mean skipping design or planning. It means sequencing the work so that you learn something real as early as possible, and reserving large investments for ideas that have survived contact with users.
Reason 6: The Wrong Team, Partner, or Contract
Choosing who builds the software matters as much as deciding what to build. Projects go wrong when the team lacks relevant experience, when the vendor is chosen on price alone, when key people leave, or when the commercial arrangement rewards the wrong behavior.
Contract structure shapes behavior. A strict fixed-price, fixed-scope contract gives the client apparent certainty but can discourage change, since every change becomes a negotiation, and can push the supplier to cut corners to protect margin. A pure time-and-materials arrangement gives flexibility but can lack incentives to control cost. Many successful engagements use a hybrid: a fixed-price discovery phase to define scope and estimates, followed by phased development with budgets and review points.
How to avoid it. Check references from projects similar in size and type, and speak to them directly. Ask to meet the people who will actually do the work, not only the sales team. Look at past work, ask how the team handled a project that went wrong, and listen for honesty. Clarify who owns the code and the intellectual property, whether you will have access to the repository throughout, and what documentation and handover you will receive. Plan for key-person risk: what happens if the lead developer leaves? Agree how disputes and changes will be handled before work begins. And prefer partners who challenge your assumptions and push back on unrealistic requests, because those who agree to everything are often storing up trouble.
Reason 7: Weak Testing, Poor Quality, and Technical Debt
Software that is rushed to meet a date often accumulates shortcuts. Tests are skipped, code is hard to read, and quick fixes pile up. This is technical debt: work that must be redone later, with interest. At first, it is invisible. Over time, each new feature takes longer and breaks more things.
The scale across the industry is substantial. A 2022 report by the Consortium for Information and Software Quality estimated that poor software quality cost the US at least 2.41 trillion dollars in 2022, with accumulated technical debt of about 1.52 trillion dollars. The same report concluded that technical debt has become the biggest obstacle to making any changes to existing code bases. These are estimates built on assumptions, and they are US-wide, but they capture the experience of many teams who find that old shortcuts make everything harder.
How to avoid it. Treat quality as part of the work, not a phase at the end. Agree on a definition of done that includes tests, review, and documentation. Use automated tests for critical paths so that changes can be made with confidence, and use continuous integration so that problems show up within minutes, not weeks. Require code review. Test with real devices, browsers, and data, not only in ideal conditions. Reserve a share of each development cycle for paying down debt and refactoring, and make the trade-off visible when deadlines tempt the team to skip it. For clients, ask to see test results and to have an independent review if the stakes are high.
Reason 8: Ignoring Users and Adoption
A system that is built, delivered, and then ignored counts as a failure, whatever the project plan says. This happens when the people who will use the software were not consulted, when it makes their work harder, or when the organization did nothing to help them change habits.
Resistance from employees shows up in the PMI data as well: employee resistance was cited in 14% of the failures it analyzed. People resist tools that feel imposed, that duplicate work, or that threaten their role, and they have good reasons to protect their productivity.
How to avoid it. Talk to the people who will use the software before design begins. Observe how they actually work, because it often differs from the documented process. Test prototypes with real users and fix the problems they find. For internal systems, plan the change as carefully as the software: communicate the reasons, train people in ways that match their roles, appoint champions in each team, and provide support in the first weeks. Decide in advance how existing data and processes will migrate and what happens to the old system, since running two systems indefinitely is a hidden cost. Measure adoption after launch and treat low usage as a problem to investigate, not as users' fault.
Reason 9: Treating Security, Performance, and Operations as Afterthoughts
Features get the attention in planning meetings. Non-functional requirements, such as security, speed, availability, accessibility, and maintainability, are often discussed late or not at all. Then the system launches, and it is slow under real traffic, exposes sensitive data, cannot be monitored, or cannot be updated without downtime.
These qualities are cheap to include early and expensive to retrofit. A site that must load quickly on mobile networks, an application that must comply with privacy rules, or a system that must stay available during business hours should have those requirements written down before design begins.
How to avoid it. Add non-functional requirements to the specification with measurable targets: page load times, expected concurrent users, uptime goals, compliance obligations. Include security practices from the beginning, such as threat modeling, dependency scanning, access controls, and secure handling of personal data. Test performance with realistic load before launch. Set up monitoring and alerting, define who responds to incidents, and keep runbooks for common problems. Plan for backups and for restoring from them, and test that. Include accessibility from the start, since fixing it late is slower and more costly.
Reason 10: Underestimated Integrations and Data Migration
Few software projects stand alone. They connect to payment providers, CRMs, accounting systems, identity services, and legacy databases. They also often need to bring in data from an older system. Both are common sources of surprise.
Third-party systems have their own limitations, documentation gaps, rate limits, and quirks. Legacy data is rarely as clean as people think, with duplicates, missing fields, inconsistent formats, and undocumented rules that only emerge when migration begins.
How to avoid it. Inventory every integration and data source at the start, and for each one find out who owns it, how it can be accessed, and what constraints it has. Run technical spikes early, small experiments that prove a risky integration works before the project depends on it. Begin data cleansing and migration planning early, and run trial migrations with real data so that issues surface while there is time to fix them. Allocate budget and time explicitly for this work, since it is often the longest and least predictable part of the schedule.
Reason 11: Budget Gaps and Hidden Running Costs
Money problems cut projects short. The PMI data lists insufficient funding as a factor in 9% of failures. Underfunding does not only mean a low initial budget. It also includes forgetting costs that appear after launch: hosting, licenses, monitoring, security updates, bug fixes, support, and continued improvement.
A launched product is not finished. Operating systems and browsers change, libraries need updating, and users ask for improvements. A budget that ends at go-live leaves no resources to keep the software healthy.
How to avoid it. Plan for the total cost of ownership over several years, not only the build cost. Include a contingency, often 15 to 25 percent for projects with significant uncertainty, and be explicit about what it covers. Decide upfront who pays for what after launch, and agree a support and maintenance arrangement. Release funds in stages tied to milestones, so that if a phase shows the idea is not working, you can stop with limited loss. This approach also guards against the sunk cost fallacy, where past spending makes it hard to stop a project that should be stopped.
Warning Signs That a Project Is Drifting
Projects rarely collapse overnight. They show symptoms first, and recognizing them early allows correction. Be concerned if there has been no working software to look at for several weeks. If status reports are green but nobody can show a demo, treat the reports with suspicion. Notice when deadlines slip repeatedly and the reasons change each time. Watch for a growing list of tasks described as nearly done, since that often means work is not actually finished or tested. Be alert when the team avoids talking about risks, or when key stakeholders stop attending meetings. Pay attention if requirements keep changing without anyone tracking the effect, if defect counts rise faster than they are fixed, or if team members leave. And notice when people begin to ask what the project is even for, which suggests the original goal has been lost.

A simple health check, repeated every few weeks, helps: Are we still solving the same problem? Is the scope stable and visible? Is progress demonstrated by working software? Are the biggest risks identified and owned? Is the budget forecast realistic? Do users and stakeholders still support the project?

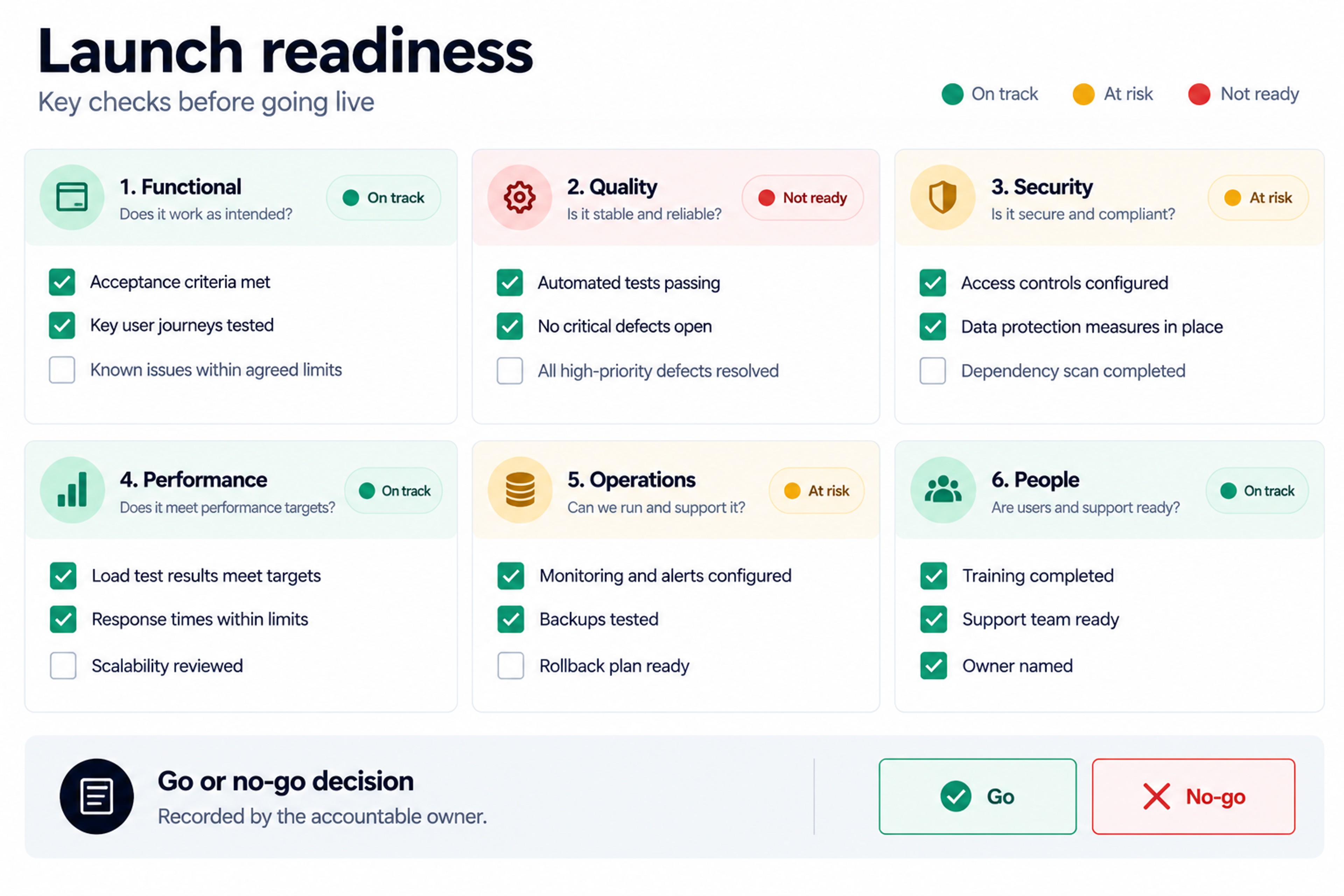

What to Do When a Project Is Already in Trouble
If your project shows several of these signs, the instinct is often to push harder: add people, extend deadlines, or demand more overtime. Those moves seldom work, and adding people to a late software project frequently makes it later because of the communication and onboarding overhead.
A better approach is to stop and reassess. Pause new feature work for a short, defined period. Gather the facts: what is built, what works, what is untested, what remains. Commission an independent review of the code and architecture if you cannot judge it yourself, which can reveal whether the foundation is sound or needs rework. Re-establish the goal and measure of success. Then cut scope to the smallest release that delivers real value, and plan it in small steps with visible demonstrations. Reset communication with the team, replacing blame with a shared understanding of the problem. And be willing to consider the hard options: switching teams, rebuilding a component, or stopping altogether if the business case no longer holds. The money already spent is gone either way. The question is whether further spending is justified by the future value.
Ten Questions to Ask Before You Start
A short set of questions at the beginning prevents many of the problems above. What problem are we solving, and for whom? How will we measure success? What is the smallest useful first release? Who is the single accountable decision-maker? Who will use this, and have we talked to them? What are the biggest unknowns and how will we test them early? How will changes to scope be handled? What integrations and data migrations are involved? What are the security, performance, and compliance requirements? And what will it cost to run and maintain after launch?
If you cannot answer most of these, you are not ready to start building, and spending a few weeks on discovery is likely to save months later. (This is a natural place to link to your content on the software development process, discovery workshops, MVP development, and QA and testing services.)
Working With a Development Partner Without Losing Control
Even when a project is outsourced, responsibility for the outcome stays with the client. A few habits keep you in control. Stay involved in decisions about priorities and trade-offs. Insist on seeing working software regularly. Keep access to the code repository, documentation, and environments from day one. Ask for transparent reporting on progress against the plan, including risks. Review quality indicators such as test coverage and defect trends. And treat the relationship as a partnership, where both sides share information openly and raise problems early.
A good partner will welcome this kind of involvement, because it makes success more likely for both sides. (Natural internal link opportunities include your pages on custom software development, website development, project rescue and code audits, and ongoing maintenance and support.)
Frequently Asked Questions
The most common reasons are unclear goals, vague or changing requirements, poor communication, unrealistic estimates, building too much before testing assumptions, weak quality practices, and a lack of user involvement. Most are management and communication problems more than technical ones.
Estimates vary because definitions differ. The Standish Group's 2020 report indicated 31% successful, 50% challenged, and 19% failed, but its methods have been criticized. A McKinsey and Oxford study of large IT projects found average overruns of 45% on budget and 7% on time, with 56% less value than predicted. Use these as signs of risk rather than exact probabilities.
There is no single cause, but unclear objectives and poor requirements appear repeatedly in the research. PMI data cited unclear or unachievable objectives and milestones in 37% of failures in 2020, and earlier work linked inaccurate requirements management to nearly half of unsuccessful projects.
Agile methods help by shortening feedback loops, delivering working software frequently, and allowing priorities to change. They do not guarantee success. They still need clear goals, engaged stakeholders, and disciplined quality practices. The principles matter more than the label.
Each has trade-offs. Fixed-price suits well-defined, small projects but can make change difficult. Time-and-materials offers flexibility but needs strong oversight. A hybrid with a fixed-price discovery phase followed by phased development is a common and often effective compromise.
Warning signs include no working demos for weeks, repeated deadline slips with shifting explanations, tasks stuck at "almost done," rising defect counts, disengaged stakeholders, and requirements changing without tracked impact. Regular health checks help catch them early.
Often, yes. Pause to assess the real state, bring in an independent technical review if needed, reconfirm the goal, cut scope to the smallest valuable release, and restore regular demos and communication. In some cases, the right decision is to stop, and that can be better than continuing to spend.
Define the problem and non-goals at the start, write testable requirements, prioritize features, and use a visible change process where each addition has an agreed effect on time and cost. Deliver in small releases so that new ideas can be scheduled for later versions.
